Agile ceremonies: A PMO’s guide from sprint to portfolio
Key Takeaways
Teams use sprint planning and the daily standup to set the sprint goal and adjust the delivery plan
Teams use sprint reviews to gather stakeholder feedback and retrospectives to improve how they work
Organizations use SAFe to extend the cadence across teams, while a shared portfolio view helps PMO leaders compare agile and phase-based work
Teams use agile ceremonies as a recurring cadence for planning work and reviewing delivery. If you’ve been in these ceremonies, you know how sprint planning is used to set the next sprint goal, while daily standups help the team adjust the plan.
During the sprint review, the team shows completed work and collects stakeholder feedback. The retrospective ends with an agreed improvement, while backlog refinement prepares upcoming work.
A PMO Director can use the outputs from these ceremonies to keep the portfolio view current. Sprint goals show what teams plan to deliver, while sprint reviews confirm what they completed. Repeated blockers and cross-team dependencies should move into scaled planning so leaders can adjust wider commitments.
Organizations using the Scaled Agile Framework (SAFe) extend the same cadence across several agile teams. SAFe calls a sprint an iteration. An Agile Release Train (ART - a group of agile teams) coordinates those teams through shared planning events.
This guide explains the five core agile ceremonies and how organizations use SAFe to extend the cadence across teams.
What are agile ceremonies?
Agile is the broader way of working, while scrum is one framework teams use to organize that work into a recurring cadence. In this article, agile ceremonies refers to the Scrum events readers commonly associate with the term: Sprint planning, the daily scrum, sprint review, and sprint retrospective.
Teams also refine the product backlog throughout the sprint so upcoming work is ready for planning. Many practitioners call backlog refinement a fifth ceremony, although Scrum treats refinement as an ongoing activity rather than a formal event.
Each ceremony has a specific role:
Sprint planning: Sets the sprint goal and confirms the work the team expects to complete
Daily scrum: Helps the team review progress and adjust its plan
Sprint review: Gives stakeholders a chance to assess completed work and shape upcoming priorities
Sprint retrospective: Helps the team agree on improvements to how it works
SAFe uses the term iteration for sprint. The team-level purpose stays the same: Set a goal and review progress. The team then adjusts the plan as new information emerges.
For PMO leaders, the useful output is a clear connection between the sprint goal and completed work. Repeated blockers and cross-team dependencies should move into scaled coordination and portfolio review.
Agile ceremony cheat sheet: From sprint to portfolio
The first five rows cover the ceremonies teams use within a sprint. The table then moves to SAFe events that coordinate work across several agile teams and connect delivery to portfolio planning.
SAFe groups those teams into an Agile Release Train (ART). Each ART plans around a Planning Interval (PI), an 8-to-12-week cycle used to align objectives and dependencies.
Ceremony | Level | Cadence | Main purpose |
Sprint planning | Team | Start of each sprint | Set the sprint goal and select realistic work from the product backlog |
Daily standup or daily scrum | Team | Daily | Review progress toward the sprint goal and adjust the day’s plan |
Sprint review | Team | End of each sprint | Show completed work and use stakeholder feedback to update priorities |
Sprint retrospective | Team | End of each sprint | Agree on improvements to how the team works |
Backlog refinement | Team | Ongoing during the sprint | Clarify upcoming backlog items and split work that is still too large |
PI planning | Agile Release Train | Every 8–12 weeks | Align the ART on PI objectives and cross-team dependencies |
ART sync | Agile Release Train | Regularly through the PI | Coordinate progress between teams and escalate blockers |
System demo | Agile Release Train | Usually each iteration | Show integrated work and review progress against PI objectives |
Inspect and adapt | Agile Release Train | End of each PI | Review PI results and turn major issues into improvement work |
Portfolio sync | Portfolio | Monthly | Review funded epics and address portfolio-level blockers |
Strategic portfolio review | Portfolio | Quarterly | Align strategy and budget before the next PI planning cycle |
Strategic investment planning | Portfolio | About twice a year | Allocate portfolio budget across value streams |
The five team ceremonies establish the delivery cadence. SAFe extends that cadence across teams and into portfolio review.
The five core agile ceremonies
Teams use five recurring ceremonies to plan work and review delivery.
1. Sprint planning: Set the sprint goal
Sprint planning opens the sprint. The team agrees on a sprint goal and selects backlog items that support it.
Purpose: Create a realistic plan for the sprint
Cadence: At the start of each sprint
Who attends: The product owner and developers attend. The scrum master facilitates
How to run it well: Bring a prioritized backlog and current capacity. End with one clear sprint goal
2. Daily standup: Adjust the plan
The daily standup, also called the daily scrum, checks progress toward the sprint goal.
Purpose: Adjust the team’s plan and identify work that needs follow-up
Cadence: Daily, usually for 15 minutes
Who attends: Developers attend. Other participants join when they contribute directly to the sprint work
How to run it well: Keep the discussion tied to the sprint goal. Move detailed problem-solving into a separate conversation
3. Sprint review: Use feedback to update priorities
The sprint review gives the team and stakeholders a shared view of completed work.
Purpose: Review the outcome and update upcoming priorities
Cadence: At the end of each sprint
Who attends: The Scrum team and relevant stakeholders attend
How to run it well: Show working outcomes and compare them with the sprint goal. Record decisions that affect upcoming work
4. Sprint retrospective: Improve how the team works
The sprint retrospective reviews how the team worked during the sprint.
Purpose: Agree on practical improvements for the next sprint
Cadence: After the sprint review
Who attends: The Scrum team attends
How to run it well: Choose one or two improvements. Assign an owner and review progress during the next retrospective
5. Backlog refinement: Prepare upcoming work
Backlog refinement clarifies future backlog items before sprint planning.
Purpose: Make upcoming work clear and manageable
Cadence: Throughout the sprint
Who attends: The product owner and developers attend. Subject-matter experts join when needed
How to run it well: Focus on work closest to delivery. Split items that are still too large
PMO leaders can use the outputs without joining each ceremony. Sprint goals show planned outcomes, while sprint reviews confirm completed work.
Repeated blockers and cross-team dependencies should move into scaled coordination and portfolio review.
Scaling agile ceremonies across teams with SAFe
SAFe adds events for decisions that involve several teams or require portfolio input. These events turn team-level outputs into cross-team commitments and funding decisions.
1. PI planning: Align teams on the next Planning Interval
PI planning brings the Agile Release Train together to agree on what it can deliver during the next Planning Interval.
The main outputs are PI objectives and cross-team dependencies. The objectives show what the ART plans to achieve, while the dependencies identify work that relies on another team.
For PMO leaders, PI planning creates a view of upcoming delivery commitments before work begins.
2. ART sync: Resolve cross-team issues during the PI
ART sync brings scrum masters, product owners, and the Release Train Engineer together during the Planning Interval.
Participants review progress and raise issues that affect more than one team. The meeting also identifies changes that could affect the PI objectives.
For PMO leaders, the ART sync shows which commitments need attention before the next planning event.
3. System demo: Review integrated work
The system demo presents the combined work produced by the ART.
Stakeholders assess the integrated outcome against the PI objectives. The demo provides stronger delivery evidence than separate team status updates.
4. Inspect and adapt: Set improvement work for the next PI
Inspect and adapt closes the Planning Interval. The ART reviews delivery results and examines the causes of recurring issues.
The event should produce specific improvement work for the next PI.
5. Portfolio sync: Review funded work
ART events coordinate delivery across teams. Portfolio events decide which work receives funding and when priorities change.
Portfolio sync usually happens monthly. Leaders review active epics and address blockers that require portfolio-level decisions.
The meeting keeps funded work visible between larger strategy reviews. Leaders can adjust an epic when its progress or expected outcome changes.
6. Strategic portfolio review: Confirm priorities before PI planning
The strategic portfolio review usually happens quarterly. Leaders review strategy and budget before ARTs plan their next cycle.
The decisions from this meeting should shape the next PI planning event. Changes to funding or expected outcomes should appear clearly in the ART’s next commitments.
7. Strategic investment planning: Allocate funding across value streams
Strategic investment planning usually happens about twice a year. Leaders assign budgets across value streams.
A value stream is the flow of work that delivers value to a customer or business area. The funding decisions from this event set the limits ARTs will plan within during the next Planning Interval.

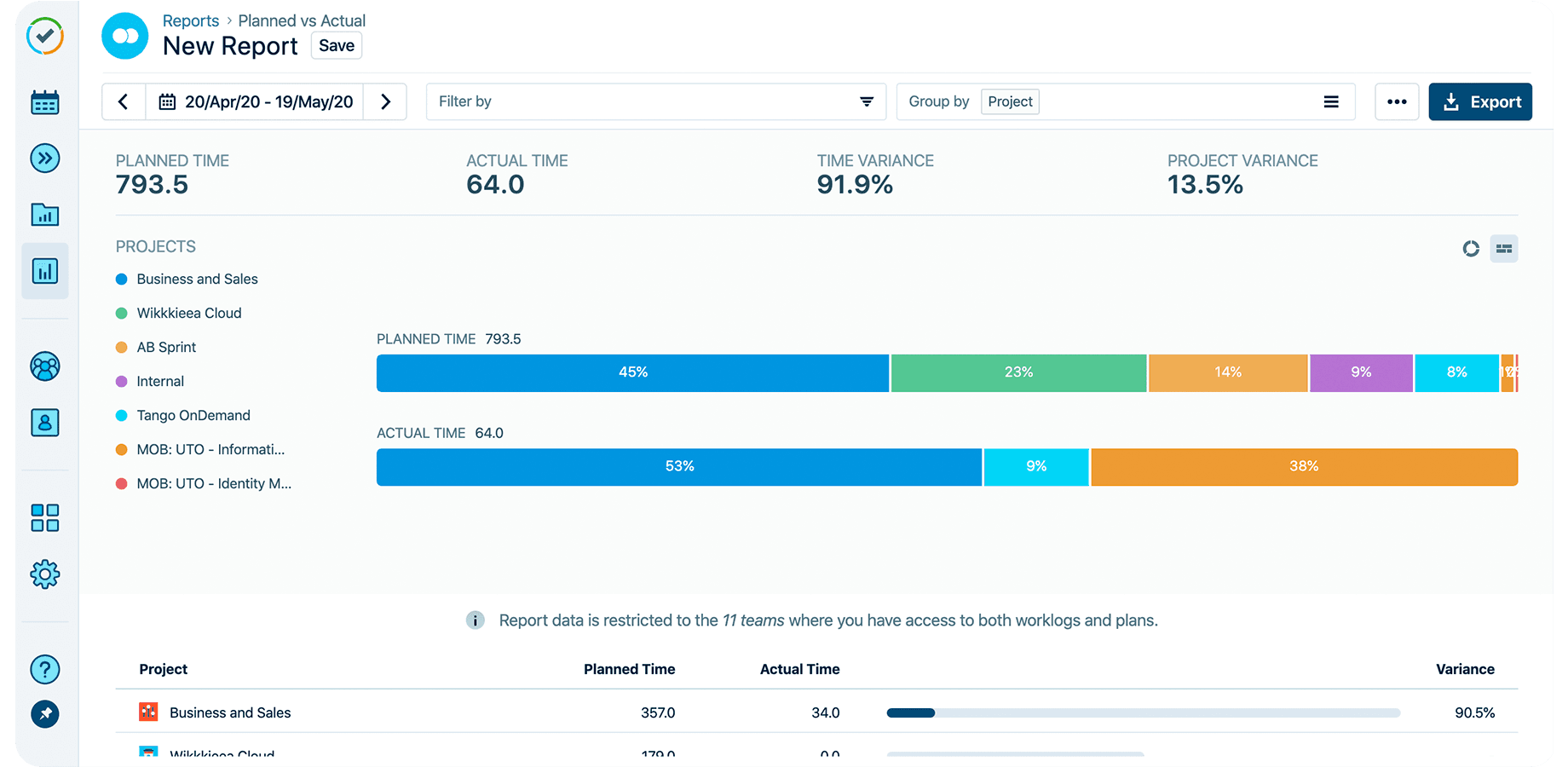

Connect portfolio reporting to the work in Jira

At a small scale, ART ceremonies help a few teams stay coordinated. At enterprise scale, the major concern is how to keep many trains visible to the same portfolio office and also connect the work to regular reports at the end of every meeting.
For example, TransUnion runs about 460 teams across 57 agile release trains globally. The dev team was already using Jira, but they tracked time in a separate system. That made their team’s worklogs harder to produce because they had to connect capitalized hours back to requirements, user stories, testing work, and production releases. The reporting work was more manual than it needed to be.
After moving time tracking into Jira with Tempo Timesheets, TransUnion reduced annual time-tracking system costs from $1 million to $62,000. It also reduced its approval workflow from 17 approvers to four levels.
The portfolio lesson here is that SAFe ceremonies are easier to act on when the delivery record is connected to the financial record. When Jira work and time data are tracked together, leaders can see which strategic goals are taking the most effort and whether that effort/work matches the plan.
How agile ceremonies work in a hybrid portfolio
Most enterprise portfolios are not just made up of SAFe ceremonies. Agile release trains may plan around PI objectives, while traditional projects may still report through milestones and phase gates.
The PMO's work is to make both delivery models readable in the same portfolio review. You don’t need every team to use the same method. You just need every initiative to roll up in a way leaders can compare.

Leaders can see which initiatives connect to ARTs and which ones sit outside a train, so they can review both delivery models in the same portfolio meeting without forcing every team to work the same way.
This also gives your portfolio sync a clearer job: Compare progress, surface risks, and make decisions from one shared view of work.
Keep agile ceremonies tied to one portfolio view with Structure PPM
Agile ceremony outputs are easier to use when teams connect them to the portfolio view. Core ceremonies produce sprint goals and delivery evidence. SAFe events add ART commitments and funding decisions.
To keep the portfolio view useful between ceremonies:
ART-level commitments should roll up to the initiatives leaders review
Traditional projects should use a format leaders can compare with agile work
This creates a clearer operating model. Portfolio sync can focus on decisions, while strategic portfolio review uses current delivery evidence instead of a manually rebuilt deck.
For Jira teams, Tempo Structure PPM brings agile and traditional work into one portfolio view. Leaders can see how ARTs connect to initiatives. They can also compare that work with projects outside the train.
Try Tempo Structure PPM for free to connect agile ceremony outputs to one portfolio view in Jira.
