Product portfolio roadmap: How to plan, prioritize, and align across product lines
Key Takeaways
A portfolio roadmap aligns product lines to strategy, a product roadmap plans one product, and a project roadmap tracks delivery
Rebuilding a roadmap by hand each cycle loses executive trust; sourcing it from live Jira data keeps every number traceable
Rank initiatives by value and capacity, then publish a view sized to each audience so executives can make decisions without digging into too much data
According to Tempo's 2026 State of SPM report, a survey of 667 planning and PMO leaders, the organizations that replan often and keep work aligned to strategy deliver measurable ROI on 81% of their projects. The ones who plan once a year deliver measurable ROI on just 45% of their projects.
The difference between the two types of organization is how often they revisit the roadmap. The teams delivering on 81% of their projects replan continuously, so the view keeps pace with the work their teams are shipping. This guide shows you how to build a product portfolio roadmap that holds up under scrutiny, and how to keep it up-to-date between reviews.
What a product portfolio roadmap is and who maintains it

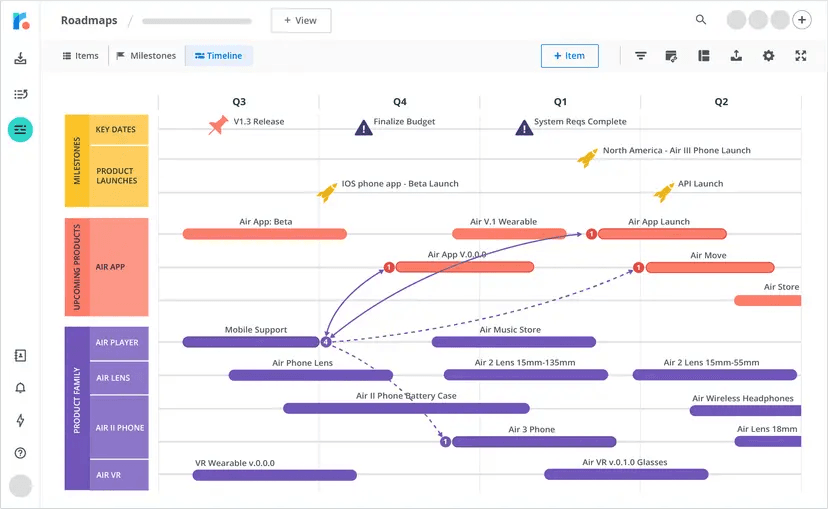

A product portfolio roadmap rolls every product and initiative into one view, organized by how each supports company strategy.
A single product roadmap plans the features of one product. The portfolio version sits a level up, showing how the whole catalog of investments fits together and where products compete for the same people and budget.
Ownership usually sits with a portfolio manager or PMO director, who keeps it fresh and presents it to leadership. The product portfolio roadmap is built for the CFO who decides what to fund.
Benefits of a product portfolio roadmap
A portfolio roadmap is useful when it helps leadership make funding decisions from current data.
Funding decisions are easier to defend: Every product line ladders to a strategic theme, so the CFO can see what each dollar supports before approving more spend
Priorities reflect capacity: Rank work against what teams have available, so the roadmap only commits to work they can deliver

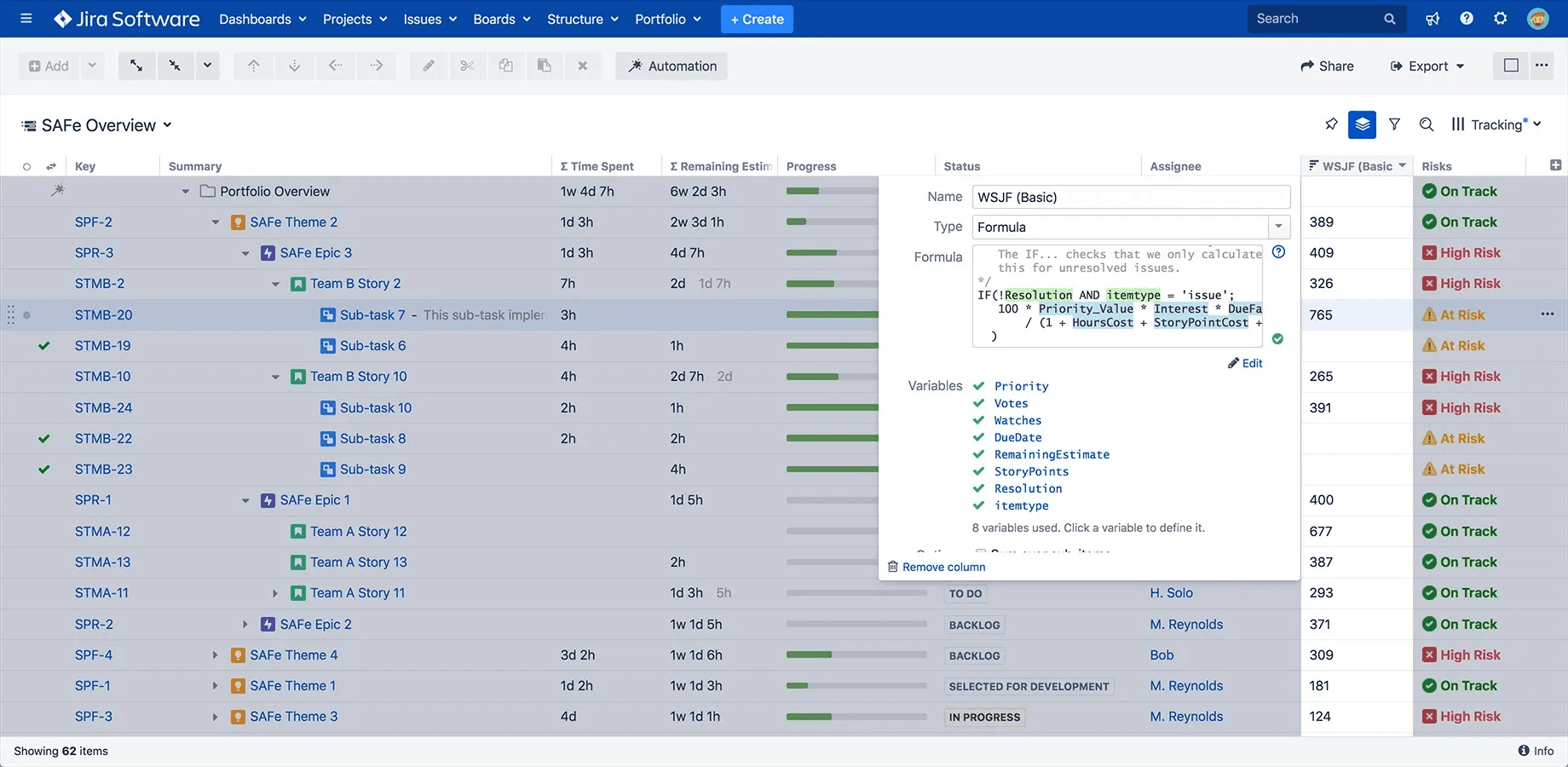

Challenged figures have a source: Each metric traces back to live Jira data, so the PMO can explain the number without rebuilding a spreadsheet to defend it
The plan stays current between reviews: The view draws from live systems, so it reflects the work teams are delivering now
In the table below, we explain how a product portfolio roadmap is different from product and project roadmaps.
Quick breakdown: product portfolio, product, and project roadmaps
These three get used interchangeably, which is how a portfolio review ends up cluttered with feature-level detail.
| Product portfolio roadmap | Single Product roadmap | Project roadmap |
Focus | Strategic: How product lines ladder up to company goals | Tactical: Features and releases for one product | Operational: Delivery of one project's scope |
Scope | Multiple products and product lines | One product | One project or program |
Timeline | Quarters to fiscal year, reviewed continuously | Rolling, release-based | Fixed start and end |
Audience | Executives, PMO, portfolio leaders | Product managers, dev teams | Project managers, delivery teams |
Key data | Initiatives, owners, status, funding, ROI | Epics, features, user stories | Tasks, milestones, dependencies |
The portfolio roadmap is the one built for funding decisions. For the delivery layer beneath it, see our guide to project roadmaps.
Why product portfolio roadmaps get outdated

Work completed, delayed or re-estimated can be missing from a deck when the leadership reviews a presentation that doesn't pull real-life data from Jira (or any other delivery system). Funding decisions then rely on an older version of the portfolio. Other reasons include

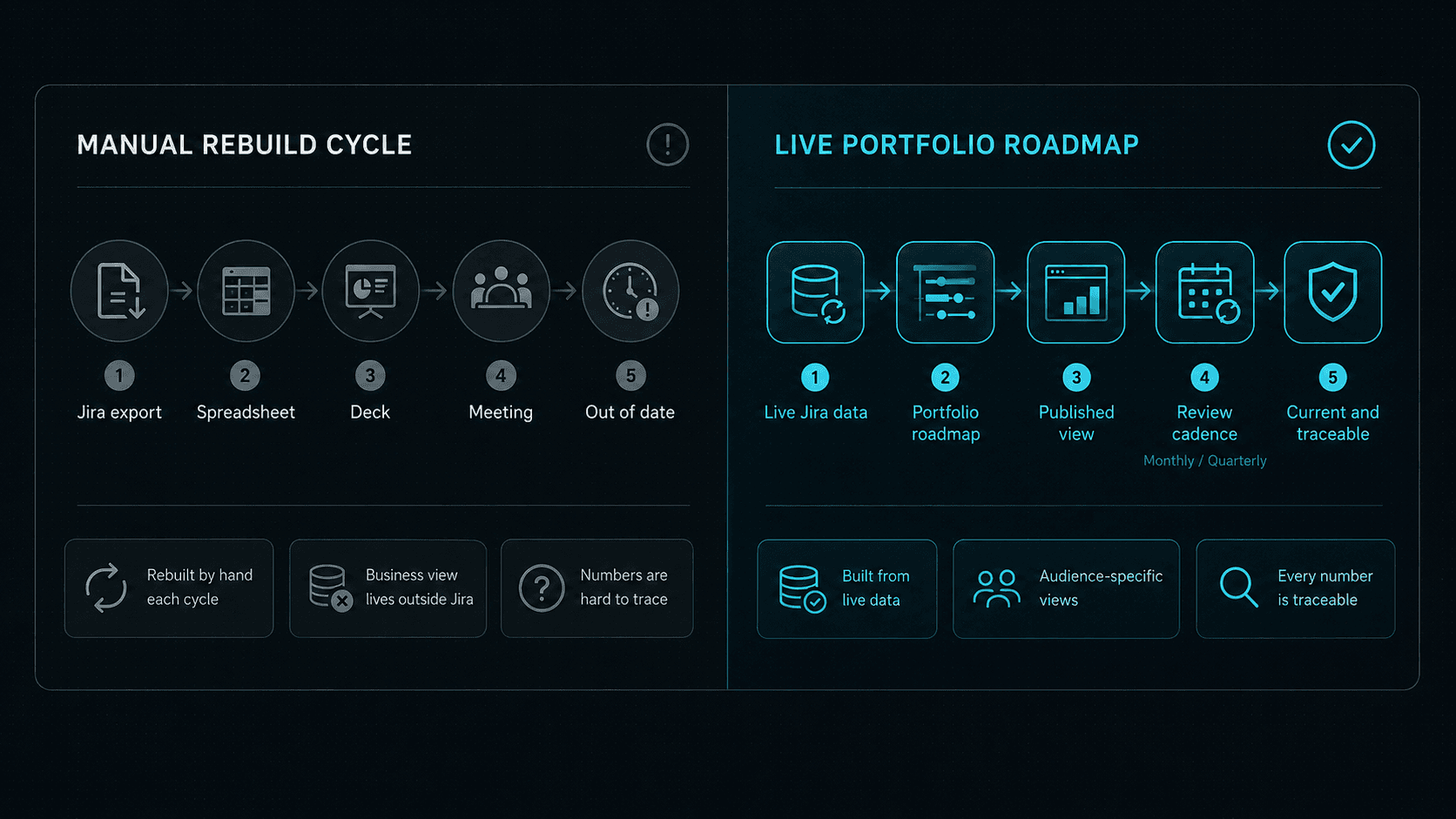

It's rebuilt by hand every cycle: Someone exports Jira tickets, rebuilds the portfolio view in a spreadsheet, then turns that spreadsheet into a deck. There are new activities in Jira by the time the deck is shared, which means the PMO has to explain differences between what leaders see in the deck and what the teams are working on in Jira.
The portfolio needs a product-level hierarchy: Jira organizes work by project and issue, while leadership reviews investment by product line. The PMO therefore needs to map Jira items to products and maintain the rollup formulas in a separate portfolio view. That mapping lets reviewers trace each portfolio figure to its Jira source.
Portfolio figures need documented lineage: Some roadmaps don't include the Jira fields and formulas behind each rollup. Assign one person to maintain that mapping, so reviewers can reproduce each figure from the source data.
This drift between plan and reality (when there's no roadmap) is expensive. According to Tempo's report, it's roughly 30 cents of every strategic dollar. On $880M of strategic spend, that's $260M a year.
A Bain & Company study points to the same misalignment problem from another angle: 88% of business transformations fail to achieve their original ambitions. A defensible roadmap needs a clearer structure as you’ll see below.
The seven elements of a defensible portfolio roadmap
Build these fields into the roadmap so leadership can read each initiative the same way:
Product hierarchy: Offerings grouped by product line, market, or theme, so the structure mirrors how leadership thinks, not how Jira stores tickets.
Dependencies: The links between initiatives, so a slip in one is visible everywhere it matters.
Prioritization: A value-and-fit ranking for each initiative, so the sequence reflects a decision, not a queue.
Timeframe: Now, next, and later horizons instead of fixed dates the plan can't keep.
Resources and spend: Track approved budget against actual spend and forecast at completion. You should also track capacity assigned to each initiative so commitments reflect real capacity.
Metrics and KPIs: Compare expected benefits with realized benefits, so you can see what has changed.
Status and ownership: A named owner and a current status, on track, at risk, or delayed, on every row.
When leadership reduces or stops funding an initiative, these fields show the budget and team capacity available for other work. The PMO can then track whether that reallocation delivers a better return.

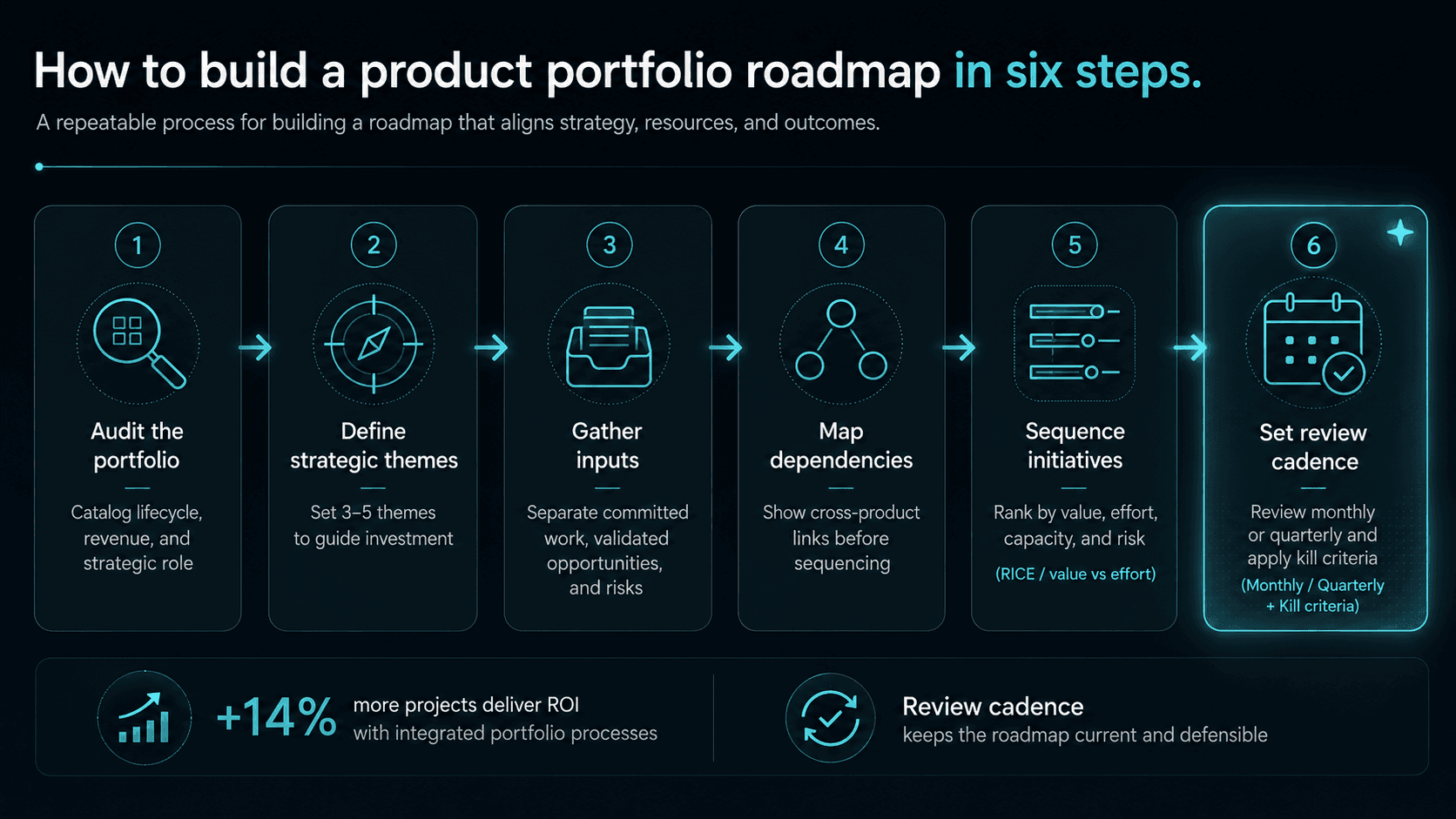

How to build a product portfolio roadmap in six steps

Organizations with integrated portfolio processes see 14% more of their projects deliver ROI than those working in silos, per the 2026 State of SPM report.
A steady review cadence keeps that integration intact. Here’s how to set up your own integrated product portfolio roadmap:
Step 1: Audit the portfolio
Start with a catalog of every active product: Its lifecycle stage (growth, maturity, decline) and its contribution to revenue. The audit forces two questions you might ignore because they aren’t top of mind:
Which products are in decline but still consuming engineering capacity?
Which are growth-stage but underfunded relative to their opportunity?
Those answers help figure out where to increase funding and reduce or stop those projects.
Step 2: Define strategic themes
From the audit, define three to five strategic themes that govern investment decisions, such as “expand to enterprise” or “reduce churn.” Every initiative must support at least one theme before it enters the roadmap. With the filter, the roadmap reflects agreed priorities instead of recent requests. And that can trigger a shift that derails all your plans for the quarter.
Step 3: Gather inputs
Collect committed work and validated opportunities. You can also gather known risks from each product team. This is because committed work has a team, timeline, and specific resources allocated to it, while validated work has evidence that it's worth building but isn't sequenced yet. Keep the two separate so a hopeful idea never gets treated as a plan.
Each team can keep its delivery method. Scrum teams can provide epics and sprint forecasts while Kanban teams provide flow and service-level data. Waterfall programs can also provide milestones and stage gates. The PMO can then map those inputs to common portfolio fields: Owner, outcome, capacity, cost, dependency, status, and review date.
Step 4: Map dependencies
Record known dependencies before sequencing, then make dependency discovery part of every review. Initiative owners can report new shared systems, approvals, vendors, data sources, and specialist roles as they emerge. And for each dependency, record an owner, required date, and effect on cost or schedule.
Re-sequence the portfolio when a new dependency changes the critical path or consumes capacity assigned elsewhere. Because two initiatives that need the same platform can't run at once unless you resource each one.
Step 5: Sequence initiatives
Rank initiatives by strategic value and effort, and factor in real capacity and risk. A value-versus-effort score or a RICE model (reach, impact, confidence, effort) keeps the ranking based on agreed criteria rather than personal preference.
You should also only commit to what the team can deliver. This is why Michiko Quinones, Principal at Data Intelligence and Architecture at Praecipio, wrote in the 2026 State of SPM report:
"Strategy fails when capacity is assumed. It succeeds when capacity is measured."
Tempo Capacity Planner uses a two-way Jira sync to convert sprint data and story points into time-based availability. The PMO can use that capacity data when deciding which initiatives can run concurrently.
Step 6: Set a review cadence
Set a recurring review, monthly for fast-moving portfolios and quarterly as a floor, so the roadmap reflects current reality instead of last quarter's assumptions. A regular review cadence separates a portfolio discipline from a portfolio document.
Decide in advance what evidence will trigger a change or stop decision. A missed milestone may call for a recovery plan. A material change in the business case or available capacity may also justify shutting down the work. But you need to test each initiative against those conditions during every portfolio review.
Tempo’s 2026 State of SPM report also found that frequent reviewers canceled 37% of projects, compared with 28.6% among infrequent reviewers. Frequent re-evaluation gives teams current evidence to adjust scope or stop funding when an initiative no longer meets its business case.
How to keep the portfolio roadmap live and fresh
Keeping a portfolio roadmap current comes down to where its data lives. Build it straight from the systems where work happens, and it stays current without a manual rebuild.
Tempo provides an integrated, modular suite that builds the portfolio roadmap on top of live Jira data. Three products handle the layers:
Tempo Structure PPM organizes Jira projects and portfolios into live hierarchies and rolls up custom formulas across them, so the business view lives in the system instead of a spreadsheet. Where Jira's native plans cap at 10,000 work items, Structure PPM builds the portfolio view across every project, so leadership reads the whole catalog as one hierarchy.
Tempo Strategic Roadmaps uses selected Jira epics or JQL results to publish audience-specific views (timeline, swimlane, or table) through a permission-controlled live URL that stakeholders open without a Roadmaps license. This way, the executive view and the delivery view come from the same data, and you don’t have to manually build each view.
Tempo Capacity Planner feeds real availability into the plan, so the roadmap commits only to work a team can take on. You can catch an over-booked team before the roadmap promises its time, which keeps the dates you show executives realistic instead of slipping once the work starts.
Together, they work as one connected governance layer. You can start where you have an immediate need and expand as the portfolio grows.
For example, Škoda Auto uses Tempo Structure PPM to manage more than 60 digital initiatives in one place. That gives its teams one system for tracking work and resource allocation across the portfolio, reliable enough to run process audits and support operational decisions.

At Staples, one product team adopted Strategic Roadmaps to show how its work connected to company strategy, something its standard office tools couldn't make visible to executives.
The executive team found the data so clear that it rolled the tool out across the company.

How a product portfolio roadmap earns executive trust
An executive portfolio review needs current financials and a traceable source for each figure. It also needs committed capacity and the funding decision leadership must make. With those inputs current, leadership can approve or revise funding from the roadmap.
Start by agreeing on what the roadmap should track and how each initiative will be reviewed. You should also give every field an owner, so the numbers stay current and are easy to trace back to the source.
Update the roadmap as the work changes by pulling live data from Jira. When delivery or capacity shifts, the view will reflect it. AI can surface those changes sooner, while leadership retains what to fund.
See how to use Strategic Roadmaps to build a live portfolio roadmap from your Jira data.
